Tribunals and CommissionsDivision Bench(2025) 10 NCLT CK 1674

Indian Bank vs M/s Ansal Properties And Infrastructure Ltd.

National Company Law Tribunal · Decided on 6 October 2025

HON’BLE JUDGES
Ravindra Chaturvedi, Member (T) · Ashok Kumar Bhardwaj, Member (J)
CASE NUMBER
IB-297/ND/2023

CourtKutchehry membership

More clarity. Every judgment.

Download court copies, explore connected cases and make more of every research session.

Loading membership options…

CourtKutchehry membership

More clarity. Every judgment.

Download court copies, explore connected cases and make more of every research session.

Loading membership options…

Ask AI about this case

AI Structured Summary

Not yet generated for this judgment

Judgment

143 paragraphs · 5,899 words

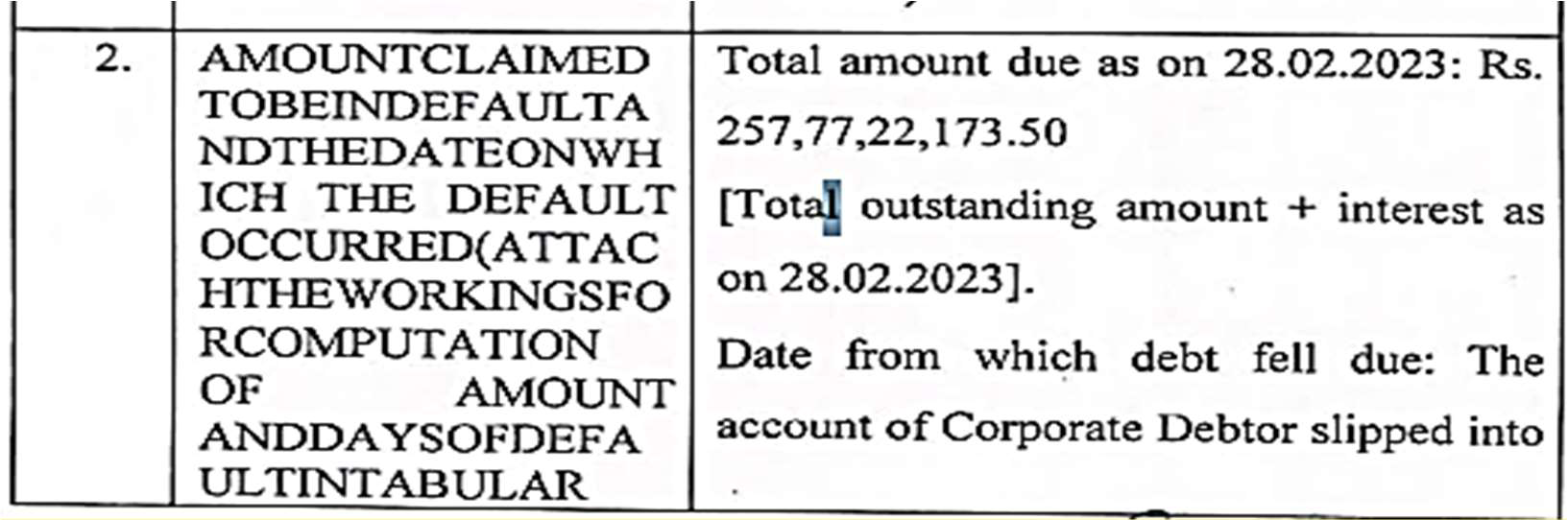

IA-/50/ND/2024:

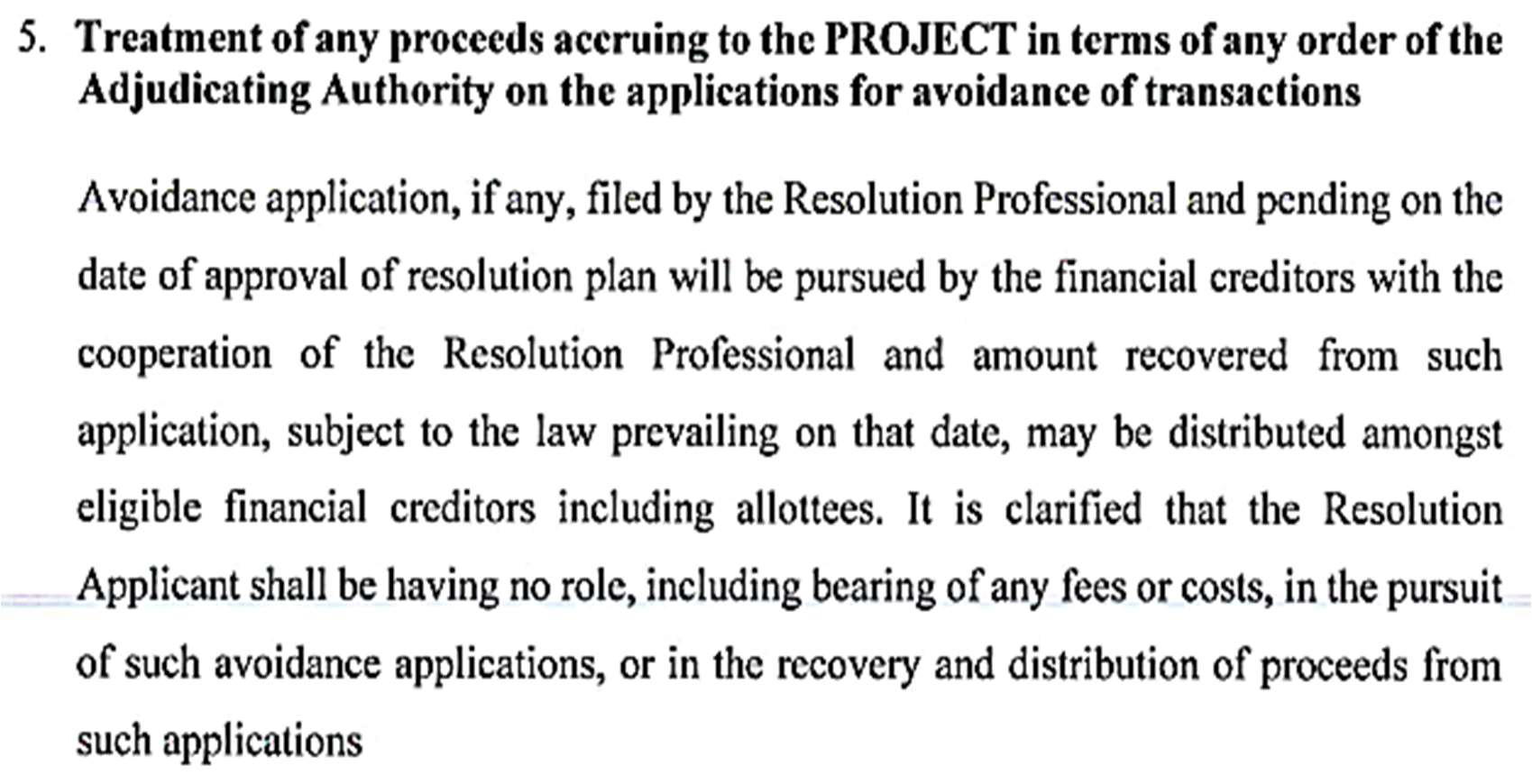

1.

The present application has been preferred under Section 30(6) of IBC, 2016 for approval of the Resolution Plan, which has already been approved by the CoC with 100 % vote shares.

2.

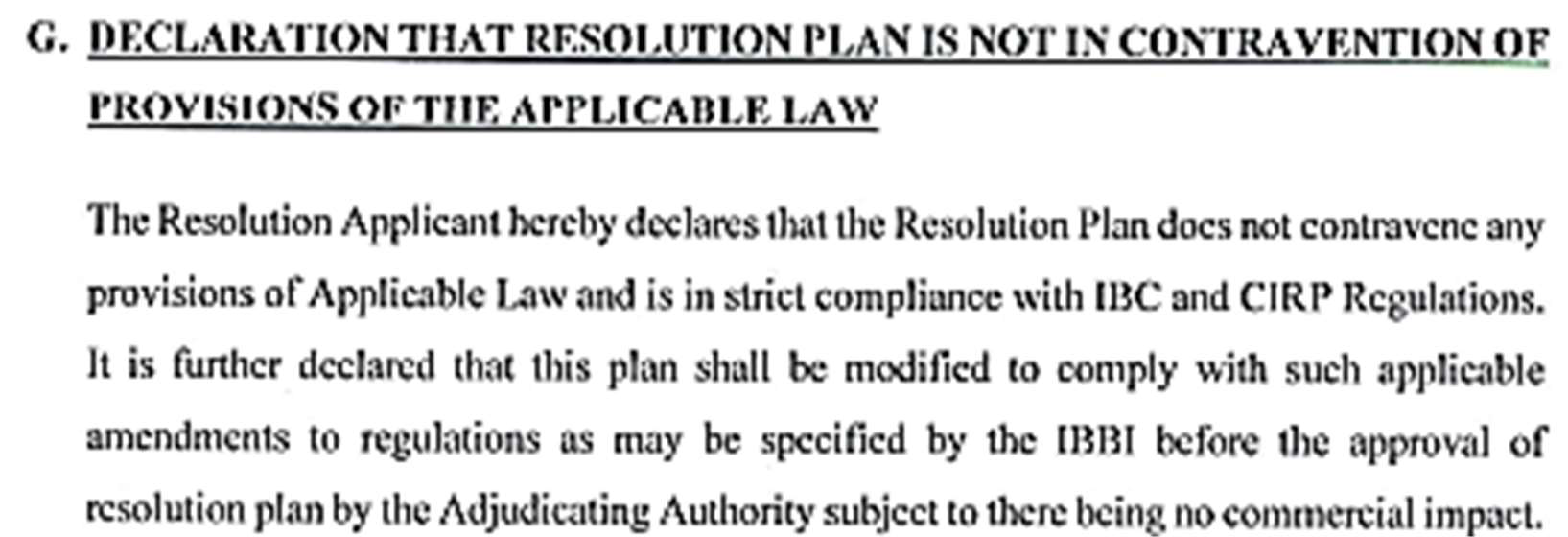

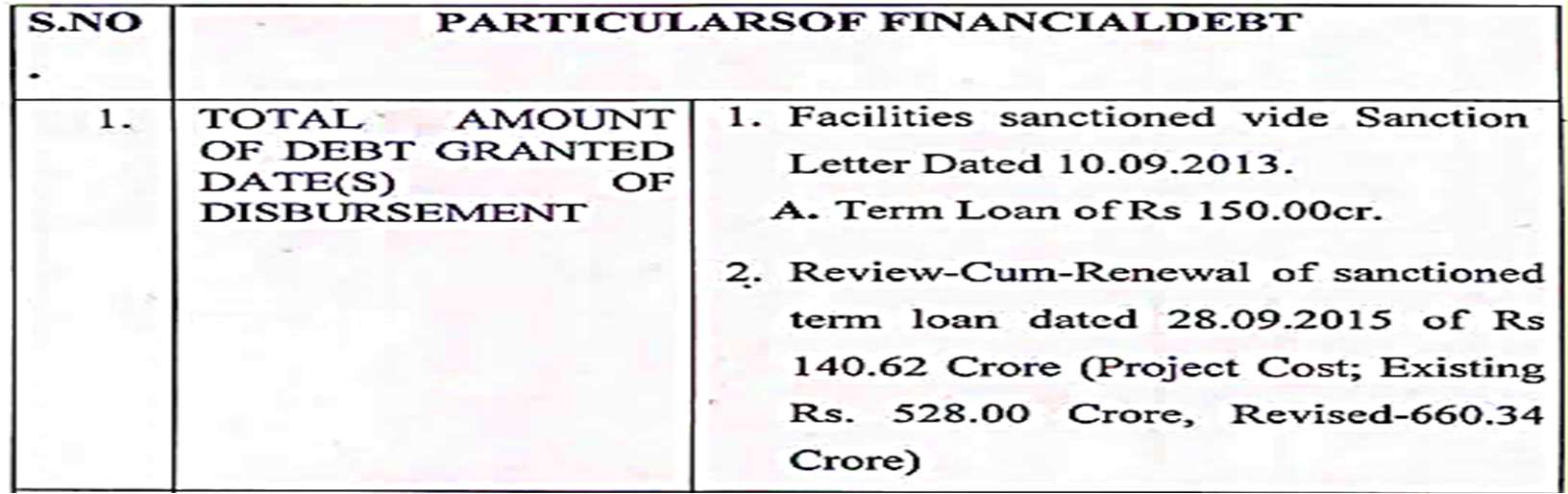

As can be seen from the Part-IV of CP(IB)-297/ND/2023, the amount of debt defaulted to be paid by the corporate debtor to the financial creditor i.e. Indian Bank was Rs. 257,77,22,173.50/-. Part-IV of the application reads thus:

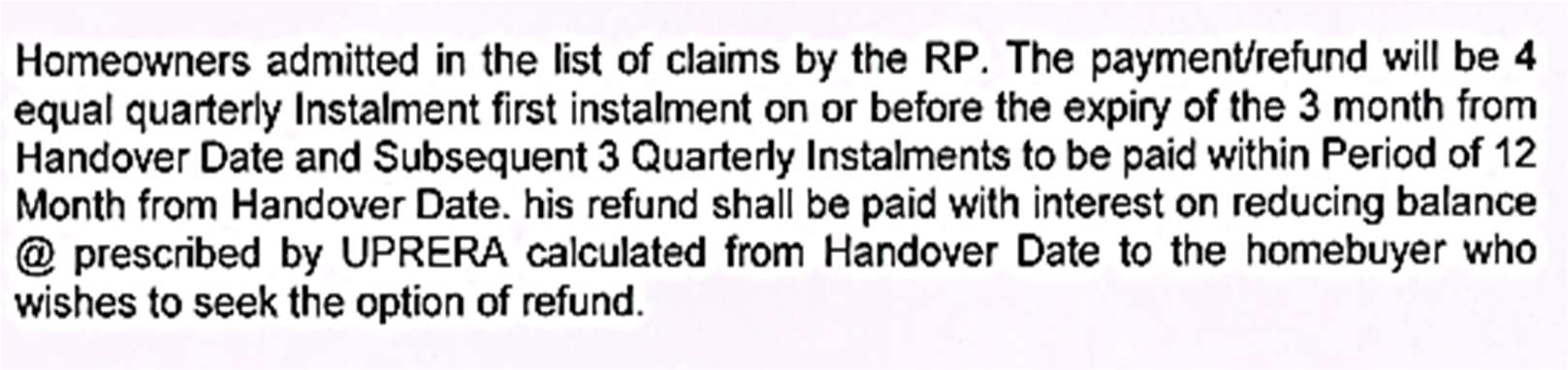

Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
3.

This Tribunal, vide order dated 20.10.2023, admitted the CIRP application qua the Corporate Debtor viz., Serene Residency Group Housing Project.

4.

The Applicant i.e. RP has enumerated the factual development/progress qua the process in the application. In response to the invitation for expression of interest, as many as 11 bidders expressed their interest to submit their resolution plan. Finally, in response to the RFRP, only two applicants could submit their plan. The plan of Apex Heights Pvt. Ltd. being approved by Members of CoC with 100 percent vote shares turned successful.

5.

The Resolution Plan demonstrates compliance with the provisions of Section 30(2) of the IBC, 2016, as it provides for the payment of CIRP costs and payment to Operational Creditors on a priority basis. The plan also provides for payment of dues to the dissenting financial creditors on priority; however, during the course of the hearing Ms. Vatsala Kak, Ld. Counsel for the RP made it clear that there is no dissenting financial creditor.

6.

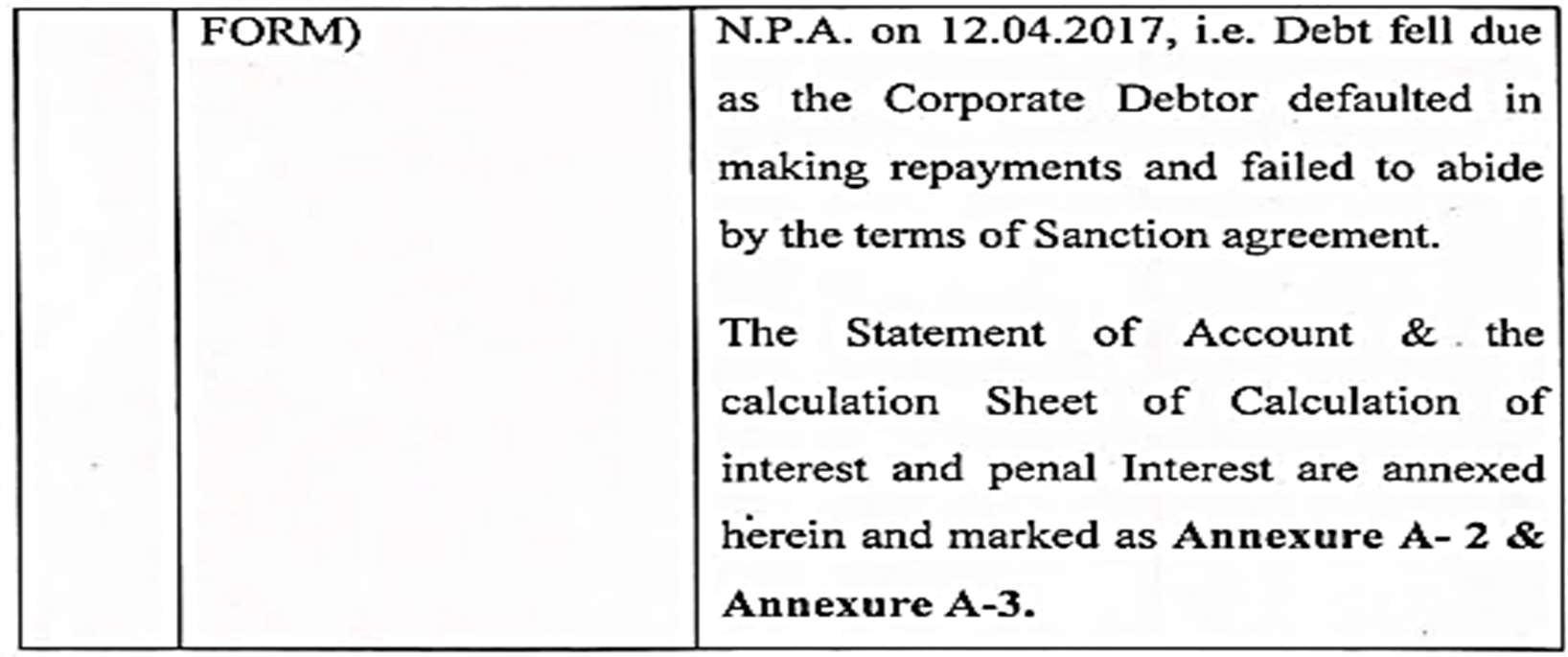

She could draw our attention to the networth/assets of the promoters /shareholders qua the SRA, to assess as to whether the SRA has the financial capacity to execute the plan. Though, we are not fully satisfied with the contents of the plan in this regard, but in any case, it is for CoC to exercise its commercial wisdom to satisfy itself on this aspect and once the CoC is satisfied that the networth of the shareholders qua the SRA can be relied upon to believe that the SRA would be capable to implement the resolution plan, in exercise of our summary jurisdiction we refrain from expressing any opinion on this aspect

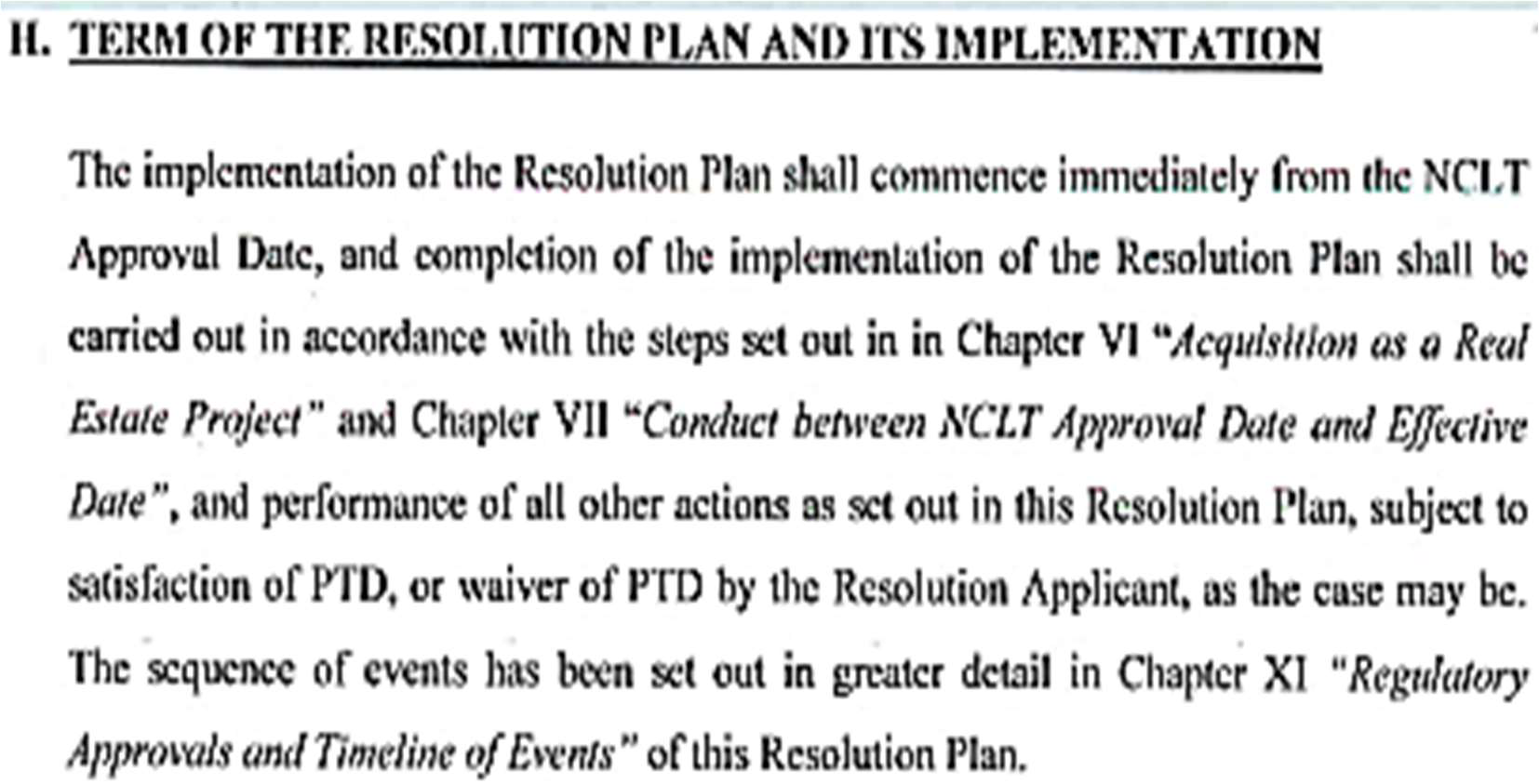

7.

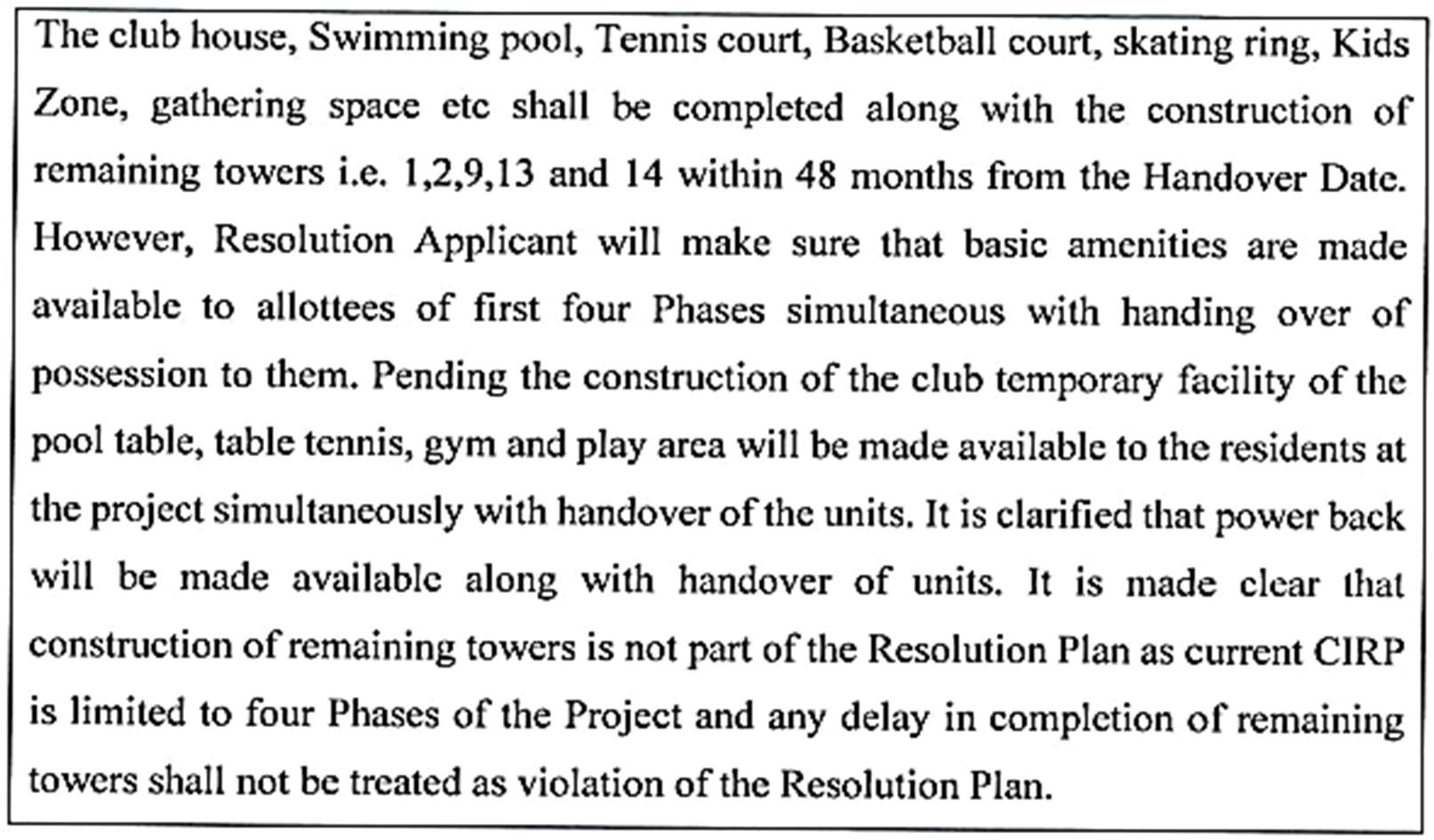

The resolution plan also contained the implementation scheduled. The relevant excerpt of key proposals contained in the resolution plan read thus:-

Exhibit reproduced from the original judgment
(a)

The claims of Secured Financial Creditors ("SFC") will be deemed to be settled in full by way of payment of Rs. 102 Crores against admitted claim of Rs. 2,91,71,53,130 being 34.96% of admitted claim. Out of this amount an amount of Rs 25.5 Crores would be paid Upfront and balance without interest will be paid in six equal quarterly instalments beginning expiry of six months from the Handover Date. On payment of the agreed amount of Rs 102 Crores, the said SFC shall release all title and security documents into the custody of the RA and issue appropriate letter/document to the RA that may be required to register satisfaction of charge with ROC/MCA, CERSAI etc.

(b)

To ensure the continuous and assured payment to Secured Financial Creditor the Resolution Applicant proposes to open an escrow account to receive the sale proceeds of the units from existing as well as future Allottees. Secured Financial Creditor will have escrow right up to 10% of sale proceeds received, the shortfall, if any, from the quarterly amount payable shall be paid by the Resolution Applicant to the Secured Financial Creditor before end of the respective quarter. In case 10% of sale proceeds received in any quarter are more than quarterly amount payable to the Secured Financial Creditor during that quarter same will be carried forward and adjusted against the amount payable to the Secured Financial Creditor in the succeeding quarter(s).

(c)

The Secured Financial Creditor shall issue necessary NOC for registering sub-lease in favour of allottees at the time of handing over possession of completed units

A2. CLAIMS OF ALLOTTEES

(a)

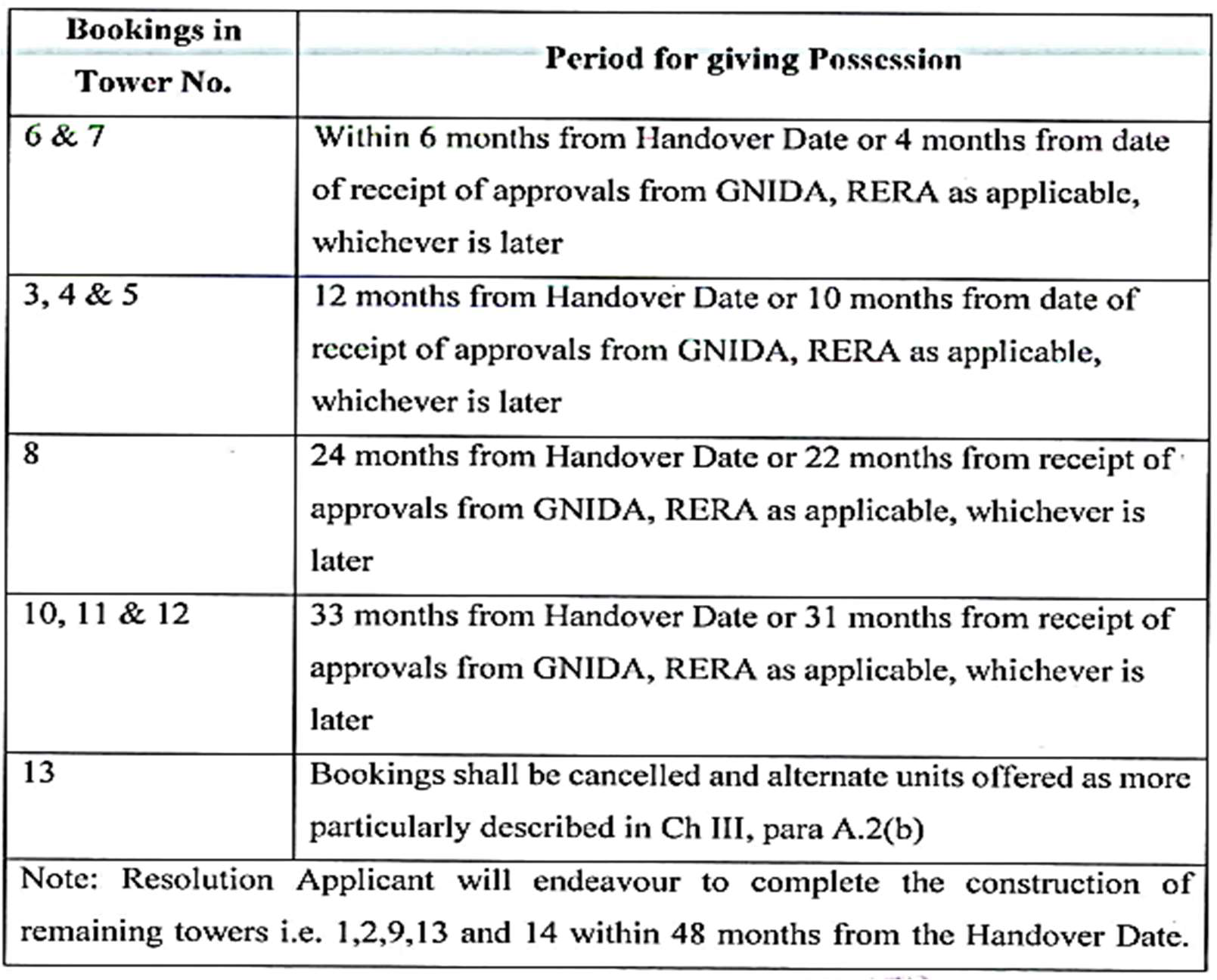

Subject to clause (b) below the RA proposes to complete the construction and hand over the units within the period (calculated from the Handover Date) as specified below subject to receiving the Balance Purchase Consideration (as applicable) which shall be construction linked:

Bookings in Tower No.Period for giving Possession
6 & 7Within 6 months from Handover Date or 4 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
3, 4 & 512 months from Handover Date or 10 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
824 months from Handover Date or 22 months from receipt of approvals from GNIDA, RERA as applicable, whichever is later
10, 11 & 1233 months from Handover Date or 31 months from receipt of approvals from GNIDA, RERA as applicable, whichever is later
13Bookings shall be cancelled and alternate units offered as more particularly described in Ch III, para A.2(b)
Note: Resolution Applicant will endeavour to complete the construction of remaining towers i.e. 1,2,9,13 and 14 within 48 months from the Handover Date.

The club house, Swimming pool, Tennis court, Basketball court, skating ring, Kids Zone, gathering space etc shall be completed along with the construction of remaining towers i.e. 1,2,9,13 and 14 within 48 months from the Handover Date. However, Resolution Applicant will make sure that basic amenities are made available to allottees of first four Phases simultaneous with handing over of possession to them. Pending the construction of the club temporary facility of the pool table, table tennis, gym and play area will be made available to the residents at the project simultaneously with handover of the units. It is clarified that power back will be made available along with handover of units. It is made clear that construction of remaining towers is not part of the Resolution Plan as current CIRP is limited to four Phases of the Project and any delay in completion of remaining towers shall not be treated as violation of the Resolution Plan.

(b)

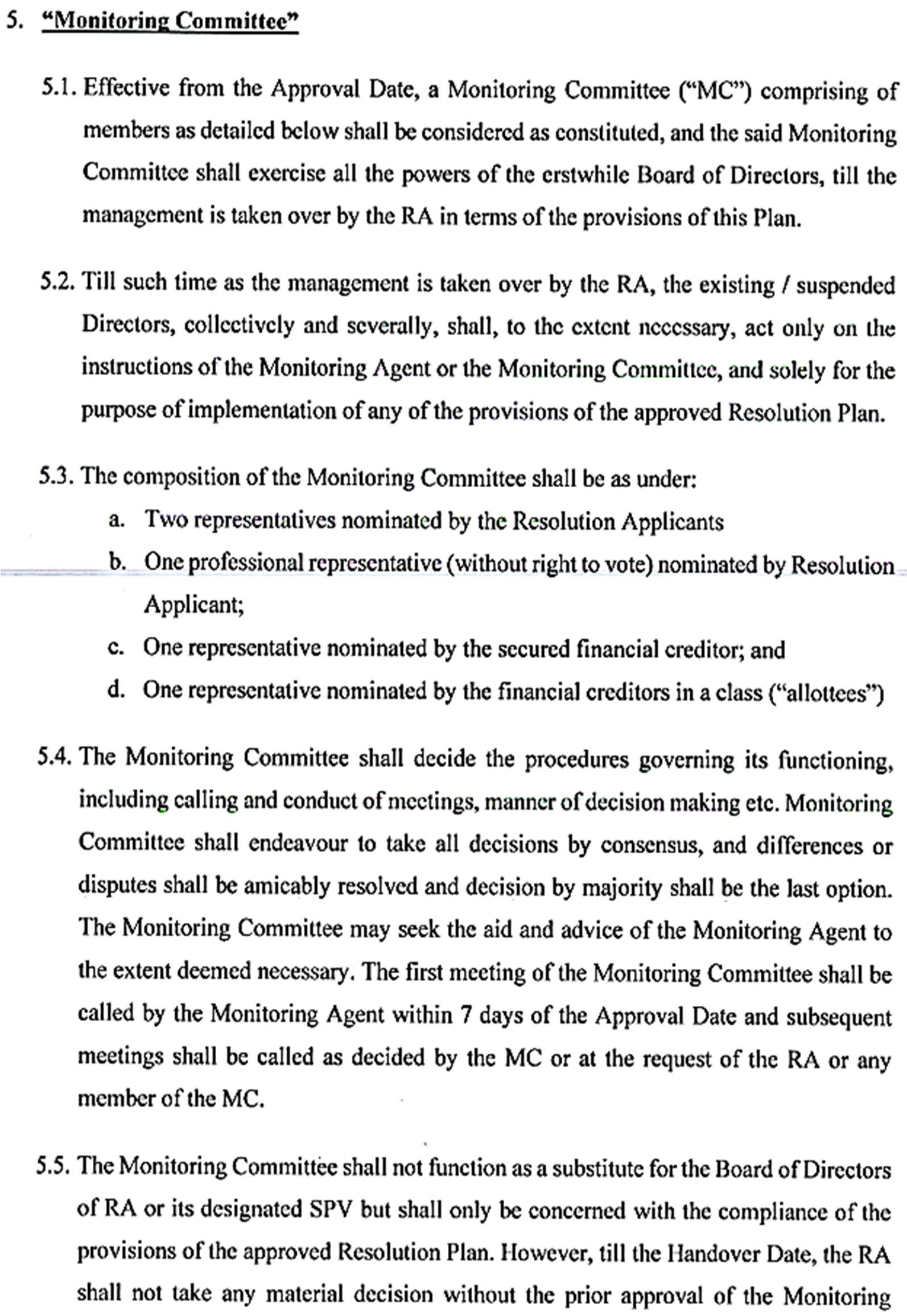

At present the building is planned with a single level basement and Resolution Applicant is of view that single level basement will not provide sufficient parking spaces. Since the per capita car ownership in the country has gone up the number of car parking planned at the project are not sufficient and thus there is need for additional parking spaces. Limited car parking space is a major cause of inconvenience in most residential housing societies that leads to chaos and conflict among residents. To overcome this problem, for present as well as future, Resolution Applicant proposes to demolish the brick-walls at ground floors in all towers except tower no. 6 & 7 (since these two towers are already handed over) and convert that area in to parking space. Resolution Applicant also proposes to build podium level parking. This will not only solve the problem of parking spaces but offer additional benefits. Parking at podium levels will offer improved security features compared to surface parking lots. This will also help create more aesthetically pleasing structures and will help alleviate traffic congestion by minimizing the need for surface parking lots, which often generate additional vehicle movements and contribute to traffic congestion, especially in densely populated areas like group housing. With podium level parking the parents can relax knowing that their children have a safe and secure environment to explore, socialize, and develop essential motor skills. Meanwhile, teenagers find a space to express themselves, whether it's perfecting tricks on their boards or simply enjoying the freedom of movement. Podium parking designs will incorporate landscaping and green spaces improving overall aesthetics of the residential complex. Overall, podium level parking will provide a range of benefits including space efficiency, enhanced security, convenience, and aesthetic appeal.

Booking of Allottees, who have booked units on the ground floor in towers 3,4,5, 8,10,11, 12 and all existing allottees in tower 13, shall be cancelled and depending upon availability equivalent units shall be allotted in the same tower or other towers on the following basis:

(i)

Resolution Applicant will compensate the affected allottees by paying 125% of PLC or Price Difference paid by the affected allottee to the Corporate Debtor in case the alternate unit offered is on a higher floor or in a non-preferential location.

(ii)

Affected allottees will be shifted to unit of same size preferably in the same tower with same facing.

(iii)

Affected allottees will be given the choice, from available unsold stock, to select the alternate unit of same saleable area. If the said allottee chooses a unit with a bigger area, then such allottee will be required to pay the price of such additional area at the then prevailing sale prices as declared by the RA. In case the RA is not in a position to offer alternate unit of the same area but offers a unit with bigger area, then, the allottee will be required to pay the price of such additional area at the original booking rate, and if the offered alternate unit is of a lower area, the RA will adjust the same at the then prevailing sale prices as declared by the RA from the amount receivable from the allottee (or refund to the allottee as the case may be).

iv) Where the RA offers an alternate unit say of size X Sq Ft which is bigger than the booked unit (say of size Y Sq Ft) but the allottee then opts for an even bigger unit (say of size Z Sq Ft), then the allottee will be required to pay differential price for X-Y Sq Ft at original booking rate, and for additional area of Z-X Sq Ft at the then prevailing sale prices as declared by the RA.

(v)

The issue of those affected allottees who have major difficulty in moving to higher floors due to physical challenges will be dealt with empathetically by the Resolution Applicant on case-to-case basis.

Subject to feasibility at the project site Resolution Applicant proposes to develop the Project as per green building standards and all the requirements of the green building standards will be satisfied.

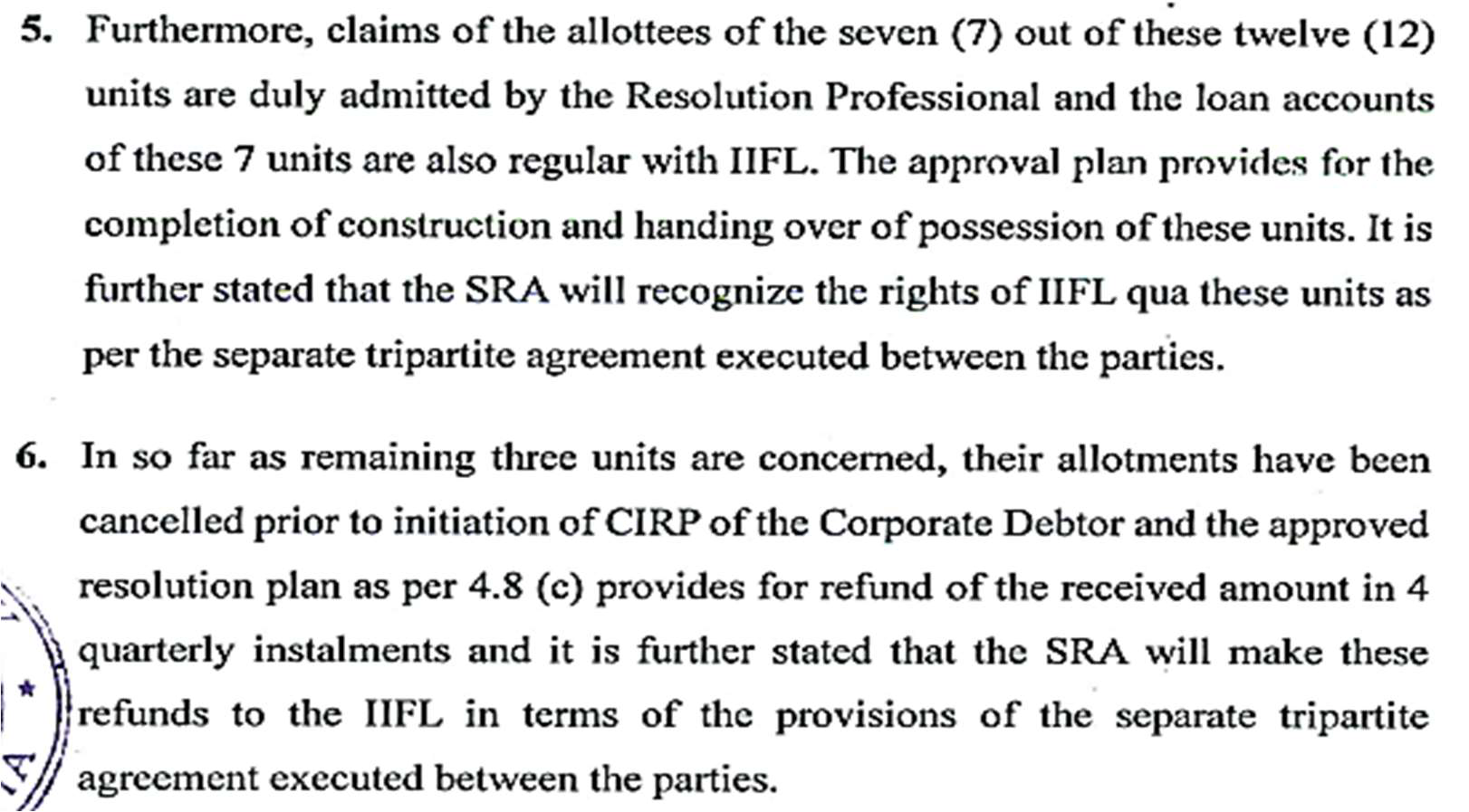

(c)

As per the information made available by the RP there are three (3) persons whose allotments have been cancelled and their claims are admitted, and amount received from them is not yet refunded. For these three persons the RA proposes to refund the amount admitted by the Resolution Professional, in 4 equal quarterly instalments, with the first instalment to be paid on or before the expiry of 3 months from Handover Date and subsequent three instalments to be paid within a period of 12 months from Handover Date.

(d)

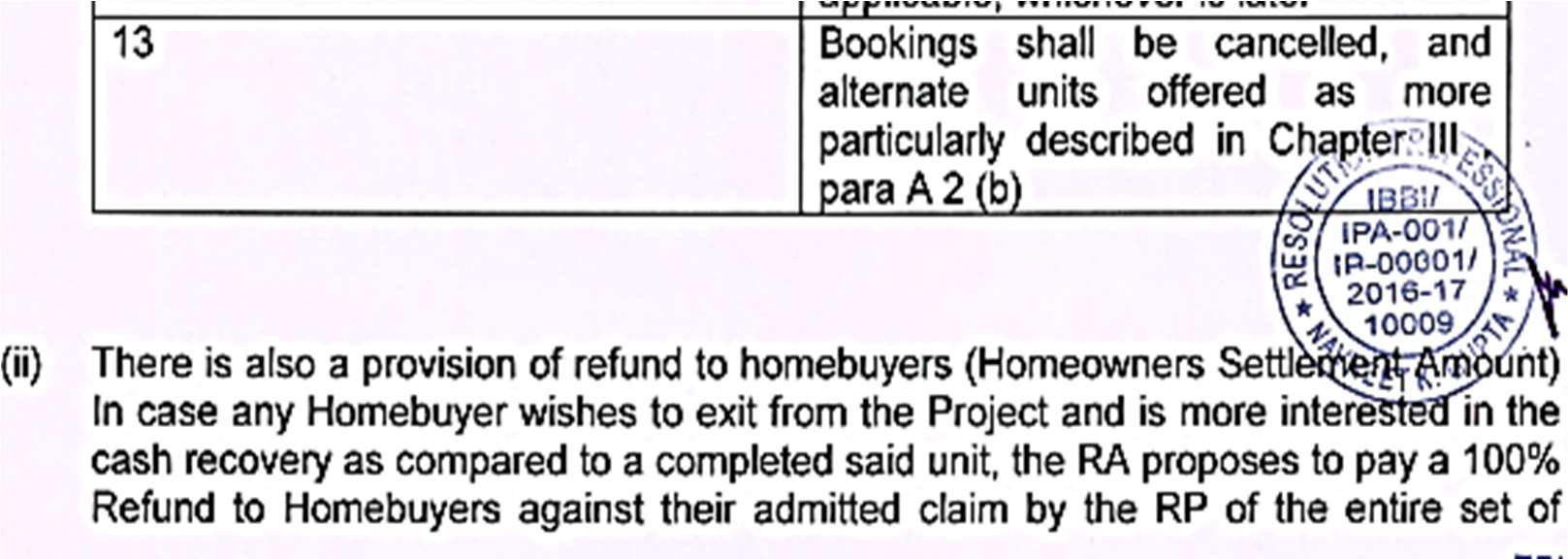

Any Allottee who does not wish to continue with the project can claim the refund of amount admitted by the Resolution Professional. Amount shall be refunded in four equal quarterly instalments, with the first instalment to be paid on or before the expiry of 3 months from Handover Date and subsequent three quarterly instalments to be paid within a period of 12 months from Handover Date. This refund shall be paid with interest on reducing balance at the rate prescribed by UPRERA calculated from the Handover Date.

(e)

For Allottees who have not filed claim in the CIRP, the Resolution Applicant proposes to give them opportunity to file their claims within 120 days of Handover Date. These Allottees will be intimated within 45 days of Handover Date through:

(i)

Individual emails being sent to email addresses, if any, available with the Corporate Debtor;

(ii)

Registered Post letters being sent to their addresses available with the Corporate Debtor; and

(iii)

Public notice in four/five leading newspapers having wide circulation in Delhi NCR Allottees who file claims with proof within 120 days shall be treated at par with those Allottees who have filed their claim in the CIRP depending upon which towers they have booked their unit. However, if any such Allottee fails to file their claim with proof within the said period of 120 days from the Handover Date their allotment shall be deemed to have been cancelled on Approval Date and their claim against the Project shall be deemed to be settled at NIL pursuant to approval of the Resolution Plan and Resolution Applicant shall not be liable to them in any manner whatsoever.

(f)

In every instance concerning the Allottees, the Resolution Applicant is entitled to authenticate the original records/documents to ascertain the legitimacy of the transaction and verify the identity of the actual Allottee. The Resolution Applicant, after scrutiny of the aforesaid documents, may require the allottee(s) to enter into a fresh builder buyer agreement or addendum / amendment to the existing builder buyer agreement to align the Builder Buyer Agreement with the terms stipulated under this Resolution Plan. In the event a fresh Builder Buyer Agreement is not executed then on approval of the Resolution Plan the existing Builder Buyer Agreement shall be deemed to be amended to give effect to the provisions of this Resolution Plan without any further deed or action. If on verification of original documents, it is found that any claim is fraudulent, frivolous, suspicious, or illegal, such claimant will not receive any Resolution Applicant Contribution or any treatment in the Resolution Plan, subject to directions, if any, of the Adjudicating Authority.

A3. ESCALATION OF CONSTRUCTION COST, BALANCE PAYMENT, GST, RERA AND LABOUR CESS

1.

Clause 3.5 of the sample builder buyer agreements shared by the Resolution Professional provides for payment of escalation of construction cost by the allottee. Due to the passage of time since the Project was launched, there has been a significant rise in the costs of material inputs (such as steel, cement, and other building materials) and services (including labour, equipment hiring costs, and fuel). Upon thorough consideration by the Resolution Applicant, it is deemed commercially unfeasible and impractical to construct and deliver the booked units at the initially agreed-upon purchase consideration, considering the escalated costs. Since it will be overly burdensome to charge complete escalated costs from the existing allottees, the Resolution Applicant proposes to recover only part of the escalated cost. The Resolution Applicant proposes to charge an amount of Rs. 250 per sq. ft. only from existing allottees of towers numbers 3, 4 and 5 and Rs. 350 per sq. ft. only from existing allottees of all other towers. Such escalation charges shall be calculated only on the saleable area as specifically mentioned in the existing Builder Buyer Agreement.

2.

Subject to the project being bankable the escalated cost and balance payment payable (other than IFMS and possession charges) shall be paid by the allottee as follows:

(i)

Different allottees have paid varying percentages of the amounts demanded before the insolvency commencement date. To ensure fairness, the Resolution Applicant shall treat all previous unpaid demands as cancelled and raise fresh demands which shall be linked to achieved stage of construction. This demand will be referred to as the "equalising demand". It is possible that in case of those who have already paid demanded amounts in full earlier, the amount payable under the "equalising demand" may be NIL.

(ii)

Equalising demand will be required to be paid within 90 days of Handover Date or 60 days of demand being raised by the Resolution Applicant, whichever is later. Any delayed payment shall be subject to payment of interest for delayed period on the defaulted amount at the rate prescribed by UPRERA.

(iii)

Other than equalising demand, other amounts demanded by the Resolution Applicant (including escalated cost) shall be linked to progress of construction and will be paid within 60 days of demand being raised. Any delayed payment shall be subject to payment of interest for delayed period on the defaulted amount at the rate prescribed by UPRERA.

3.

Corporate Debtor has raised demand on existing allottees on the area which is over and above the area as specifically mentioned in the existing Builder Buyer Agreement. It is clarified that for the purpose of booked unit area by the Allottee the Resolution Applicant will consider only that super area which is specifically mentioned in the existing Builder Buyer Agreement as executed between the existing allottees and Corporate Debtor. It is clarified that demand on this count previously raised by the CD shall be deemed to have been cancelled and fresh demand will be raised as per the Resolution Plan.

4.

GST, if any, applicable and payable on the residential units shall be paid by the respective allottee(s). It is clarified that the GST as referred to in this clause or elsewhere in the Resolution Plan shall be payable by the allottee only on the future payment being made by the allottees. It is clarified that any GST already paid by the allottees to the Corporate Debtor and not deposited by the Corporate Debtor with the GST Department shall not be again payable by the allottees.

5.

It is explicitly made clear that the amount, if any, payable under The Building and Other Constructions Workers Welfare Cess Act, 1996 shall be collected from the allottee(s) on pro rata basis net of payment made, if any, under this head by the allottee.

6.

It is explicitly made clear that Allottee(s) and Resolution Applicant both are bound by the provisions of RERA, 2016 and rules/notifications/order/circulars issued thereunder unless modified or amended or waived by virtue of this Resolution Plan.

8.

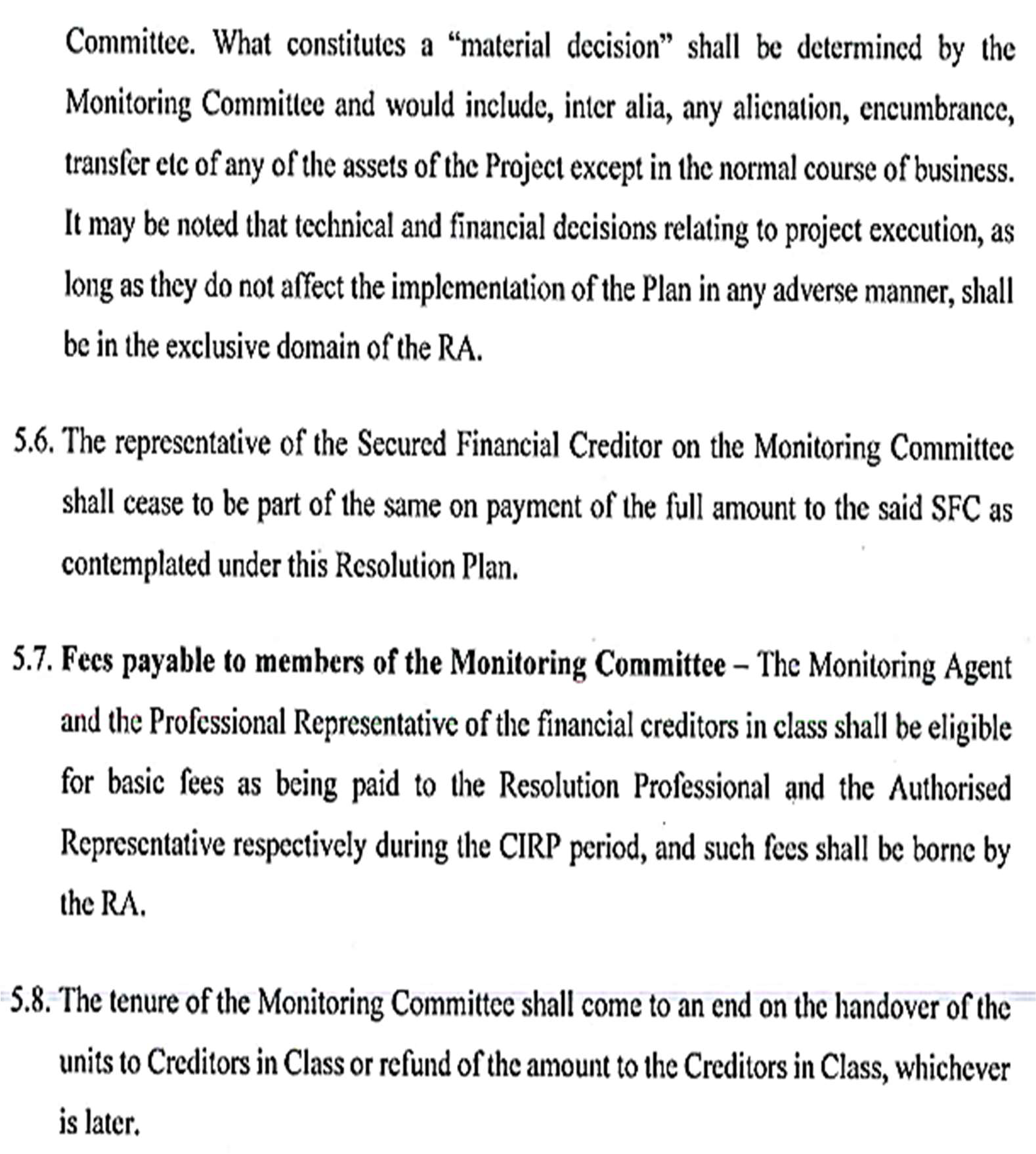

To ensure proper supervision over the implementation of the resolution plan, the plan provides for the constitution of a Monitoring Committee. The relevant provision in this regard reads as follows:

Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
9.

The RP has given a certificate in the prescribed form viz. Form H, stating that the resolution plan is not in the violation of provisions of law. It is also certified by the RP that the Resolution plan meets the criteria approved prescribed by the CoC having regard to the complexity and scale of operation of the business of the CD.

10.

It has also been certified by the RP that the plan is in due deference of the provisions of Regulations 37, 38 and 39 of the IBBI (CIRP) Regulations, 2016. The RP has also certified that the SRA has submitted performance bank guarantee in form of fixed-term deposit of an amount of Rs. 8 crore by creating lien in favour of Indian Bank. The RP has specified the compliance of IBC and relevant resolutions framed by IBBI thereunder as follows:-

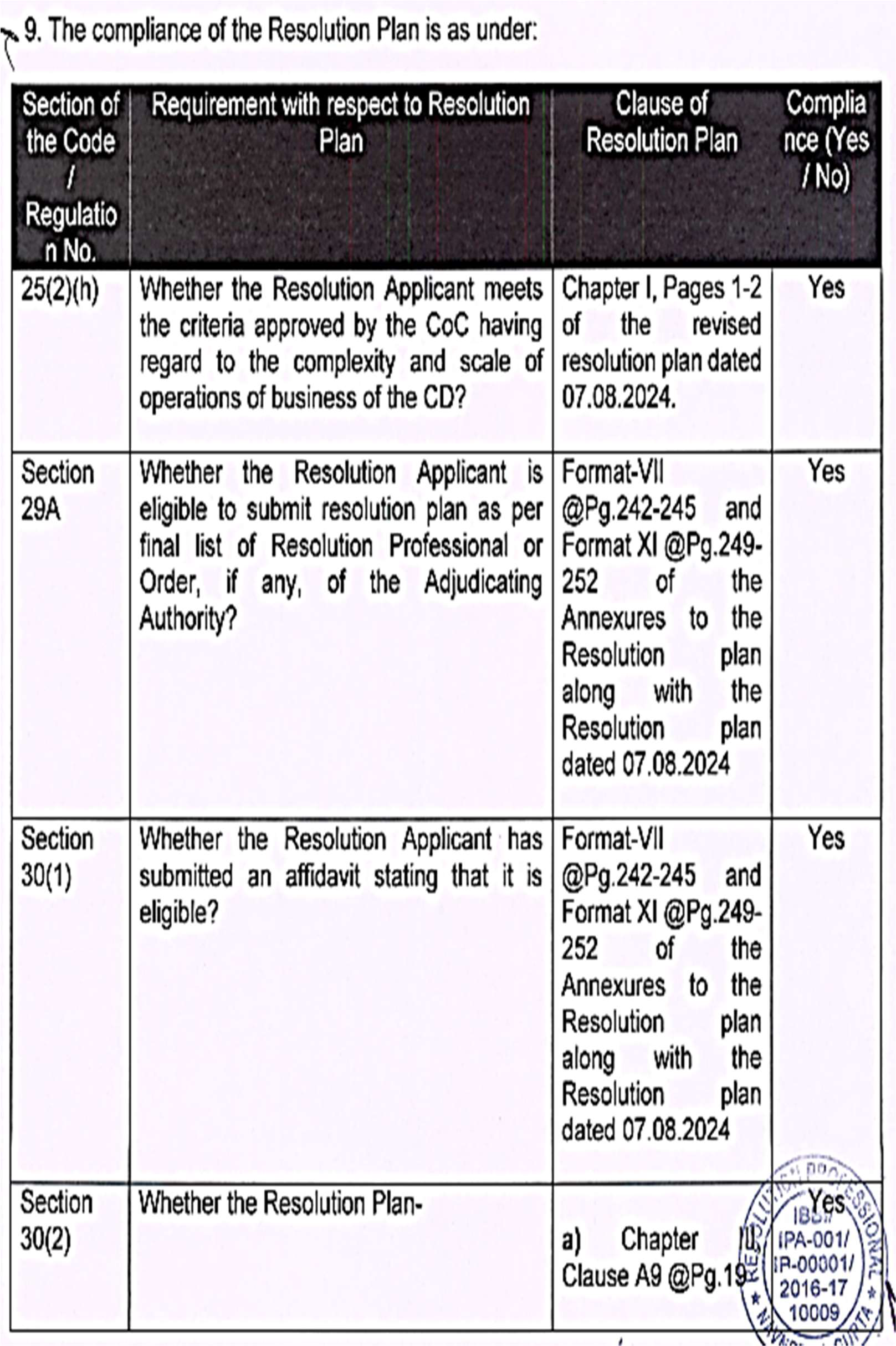

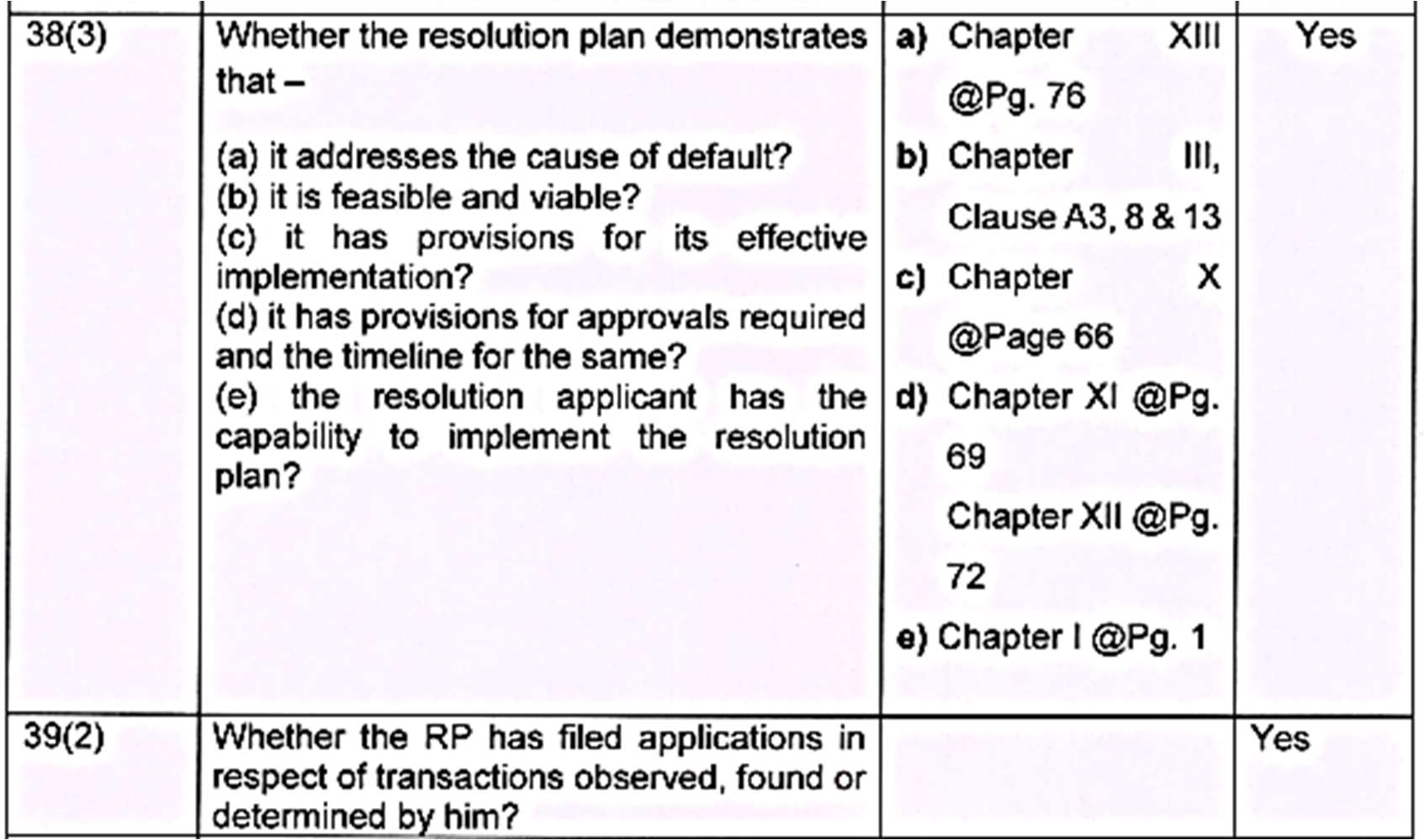

Exhibit reproduced from the original judgment
(a) provides for the payment of insolvency resolution process costs?Chapter IV Clause 4.3 @Pg.31;
(b) provides for the payment to the operational creditors?b) Chapter III Clause A5 @ Pg. 16 (Workmen & Employees)
(c) provides for the payment to the financial creditors who did not vote in favour of the resolution plan?Chapter IV Clause 4.4. @Pg. 31 (Workmen & Employees)
(d) provides for the management of the affairs of the corporate debtor?Chapter III Clause A6 @ Pg. 16 (Statutory Authorities)
(e) provides for the implementation and supervision of the resolution plan?Chapter IV Clause 4.5 @Pg. 32 (Government & Statutory Authority)
(f) contravenes any of the provisions of the law for the time being in force?Chapter III Clause A7 @ pg. 17 (OC)
Chapter III Clause B @Pg. 22 (Financial Proposal)
c) Chapter III Clause A14 @ Pg. 21 (DFC)
Chapter IV Clause 4.6 @Pg. 32 (DFC)
d) Chapter IX @Pg. 65
e) Chapter X @Pg. 66 Chapter VI @Pg. 48
f) Chapter III Clause G @Pg. 28
Section 30(4)Whether the Resolution Plan (a) is feasible and viable, according to the CoC? (b) has been approved by the CoC with 66% voting share?(a) In the 12th meeting of the CoC, the AR of the Homebuyers apprised the CoC that the Resolution plan of Apex HeightsYes, PP 1880 IPA-00 IP-0000 2016-1 1000 MINEET K
Private Limited has been evaluated on the quantitative and qualitative parameters enshrined in the evaluation matrix and the compliant resolution plan of Apex Heights has been found to be more feasible and viable. Additionally, the CoC relied on the feasibility and viability report prepared by Cushman and Wakefield to conclude that the Resolution plan of Apex Height Private Limited is more feasible and viable compared to Zapstar's Plan. (b) Yes, the Resolution plan has been approved with 100% voting share.
Section 31(1)Whether the Resolution Plan has provisions for its effective implementation plan, according to the CoC?Chapter-IX, X and XI at Pages 65-71 of the revised resolution plan provides for the provisions for effective implementation.Yes
Regulation 38 (1)Whether the amount due to the operational creditors under the resolution plan has been given priority in payment over financial creditors?Chapter III Clause A5 @ Pg. 16 (Workmen & Employees) Chapter IV Clause 4.4. @Pg. 31 (Workmen & Employees) Chapter III Clause A6 @ Pg. 16 (Statutory Authorities) Chapter IV Clause 4.5 @Pg. 32 (Government & Statutory Authority) Chapter III Clause A7 @ pg. 17 (OC)Yes
Chapter III Clause B @Pg. 22 (Financial Proposal)
Regulation 38(1A)Whether the resolution plan includes a statement as to how it has dealt with the interests of all stakeholders?Chapter V Para 6 @Page 45Yes
Regulation 38(1B)(i) Whether the Resolution Applicant or any of its related parties has failed to implement or contributed to the failure of implementation of any resolution plan approved under the Code. (ii) If so, whether the Resolution Applicant has submitted the statement giving details of such non-implementation?Chapter III Clause I @Pg. 28No
Regulation 38(2)Whether the Resolution Plan provides: (a) the term of the plan and its implementation schedule? (b) for the management and control of the business of the corporate debtor during its term? (c) adequate means for supervising its implementation?a) Chapter III Clause H @Pg. 28 Chapter XI Clause 6 @Pg.69 b) Chapter X Clause D and E @Pg. 67-68 c) Chapter VI Clause 4 & 5 @Pg. 53-55Yes
Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment

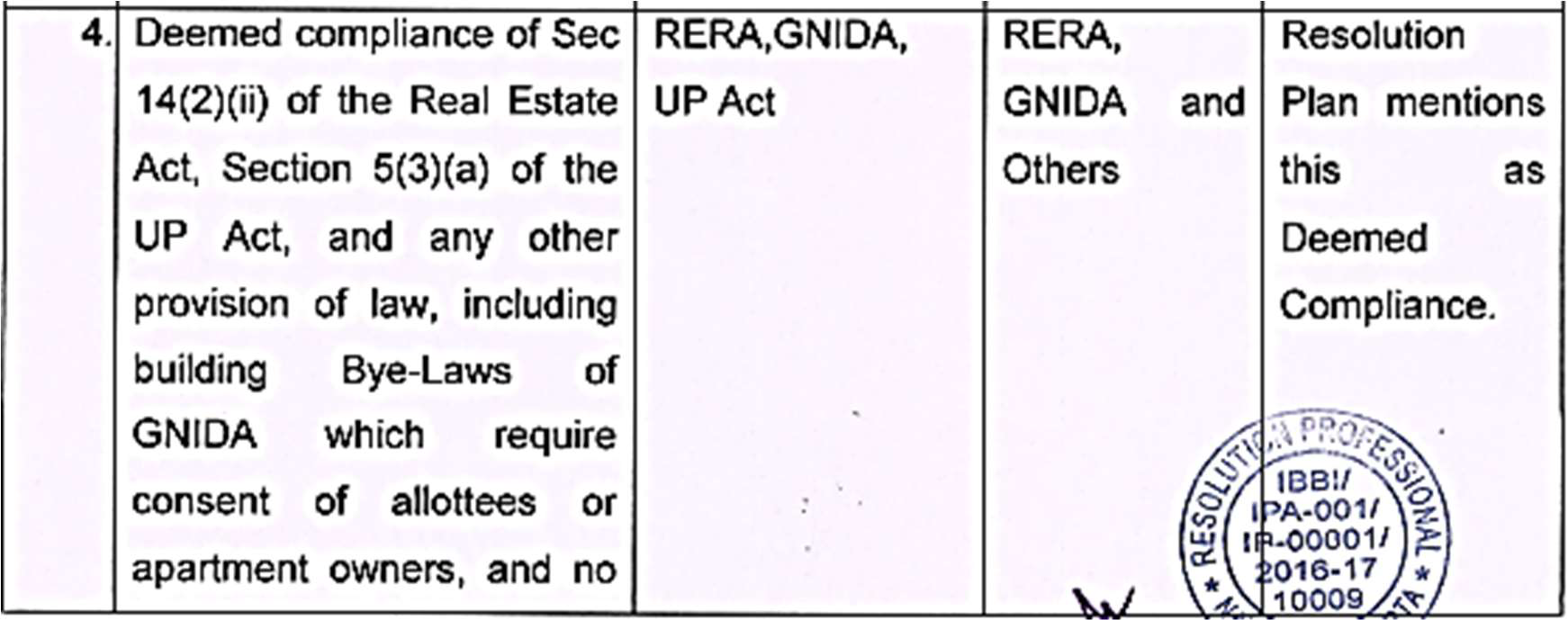

Exhibit reproduced from the original judgment
11.

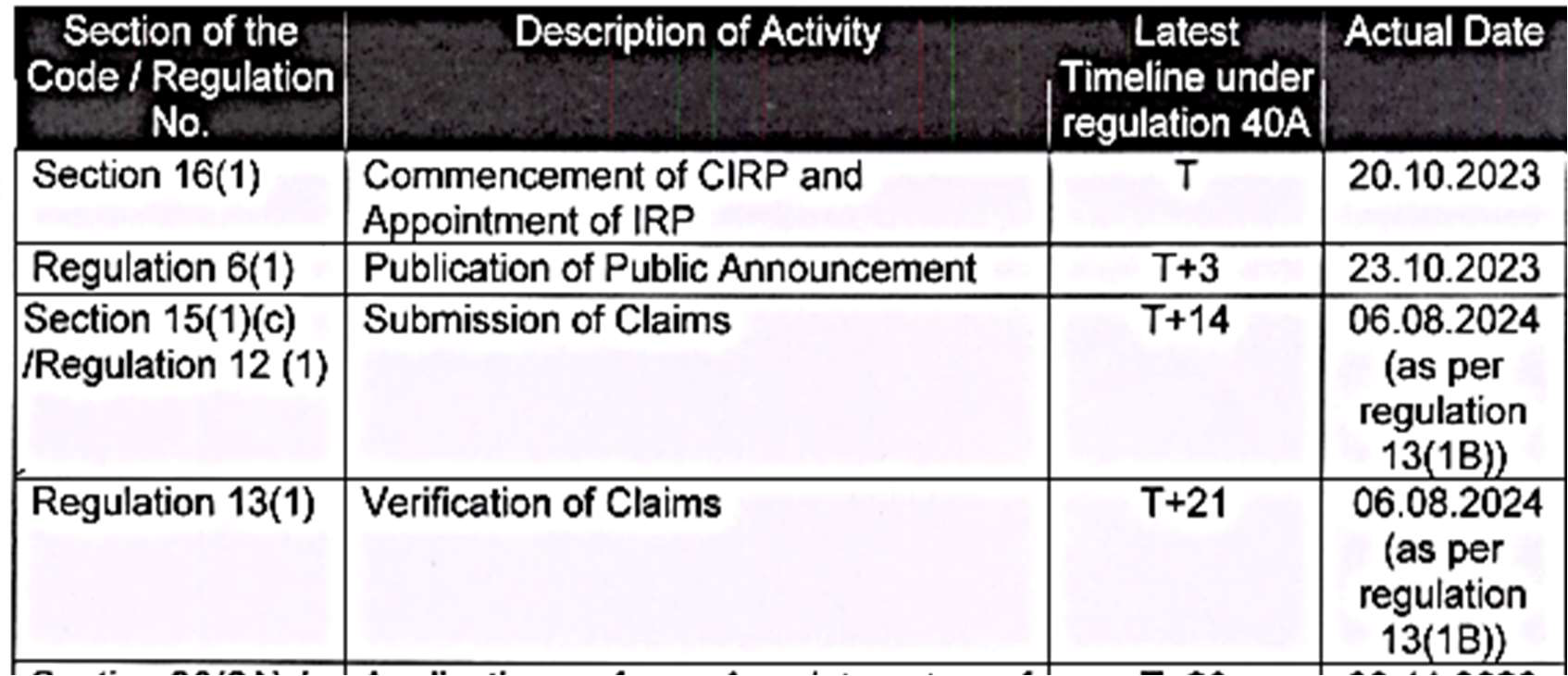

The RP has given the various steps taken during CIRP and consumed in taking the same as under:-

Exhibit reproduced from the original judgment
Section 26(6A) / Regulation 15AApplication for Appointment of Authorised Representative, if necessaryT+2309.11.2023
Regulation 17(1)Filing of Report Certifying Constitution of CoCT+2313.11.2023
Section 22(1) and regulation 17(2)First Meeting of the CoCT+3015.12.2023
Regulation 35ADetermination of fraudulent and other transactionsT+11505.08.2024
Regulation 27Appointment of two Registered ValuersT+4702.12.2023 And 3rd Valuer Appointed on 20.04.2024
Regulation 36 (1)Submission of Information Memorandum to CoCT+9513.02.2024
Regulation 36AInvitation of EoIT+6019.12.2023 (Further Addendum to Form-G was published on 06.01.2024)
Publication of Form GT+6019.12.2023 (Further Addendum to Form-G was published on 06.01.2024)
Provisional List of Resolution ApplicantsT+8524.01.2024
Final List of Resolution ApplicantsT+10008.02.2024
Regulation 36BIssue of Request for Resolution Plan, which includes Evaluation Matrix and Information Memorandum to Resolution ApplicantsT+10501.02.2024 & 13.02.2024
Section 30(6) / Regulation 39(4)Submission of CoC approved Resolution PlanT+16505.09.2024
Section 31(1)Approval of Resolution PlanT+180As per the orders of the Hon'ble
Adjudicating Authority
12.

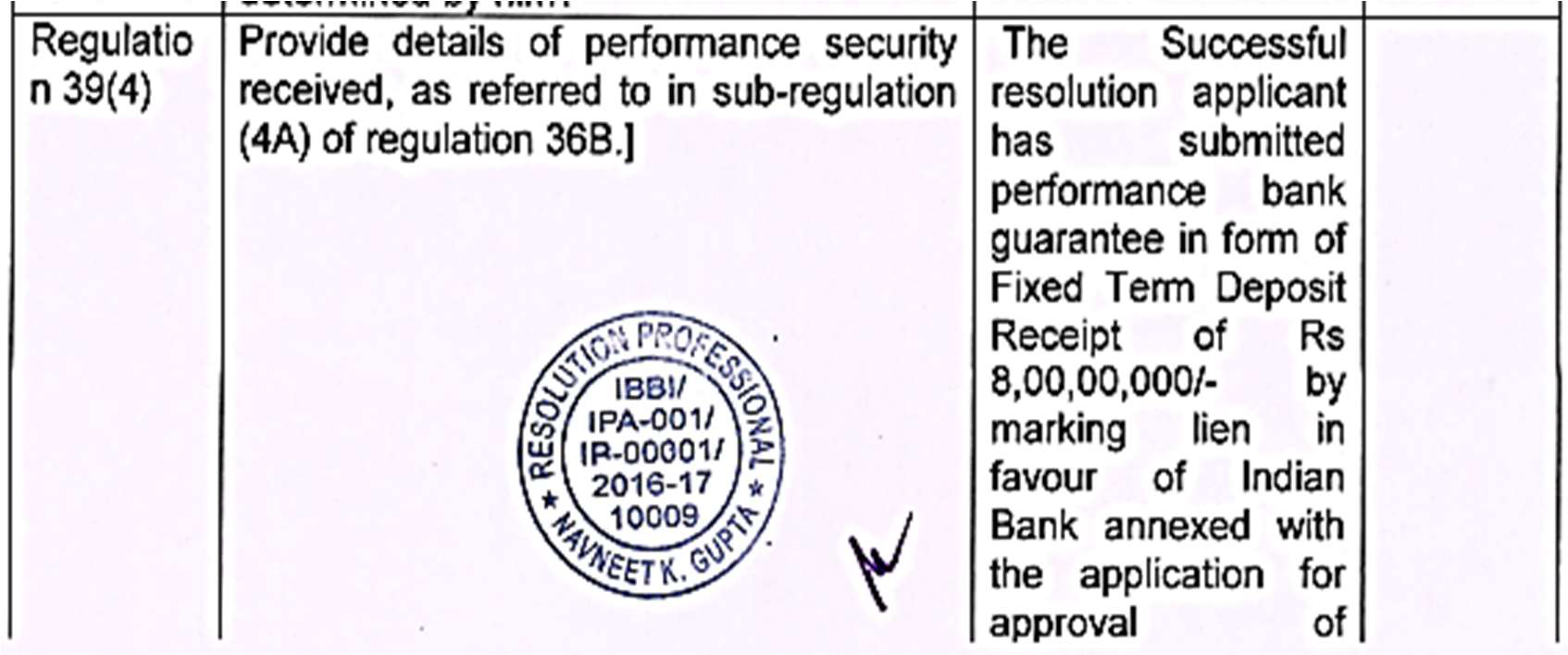

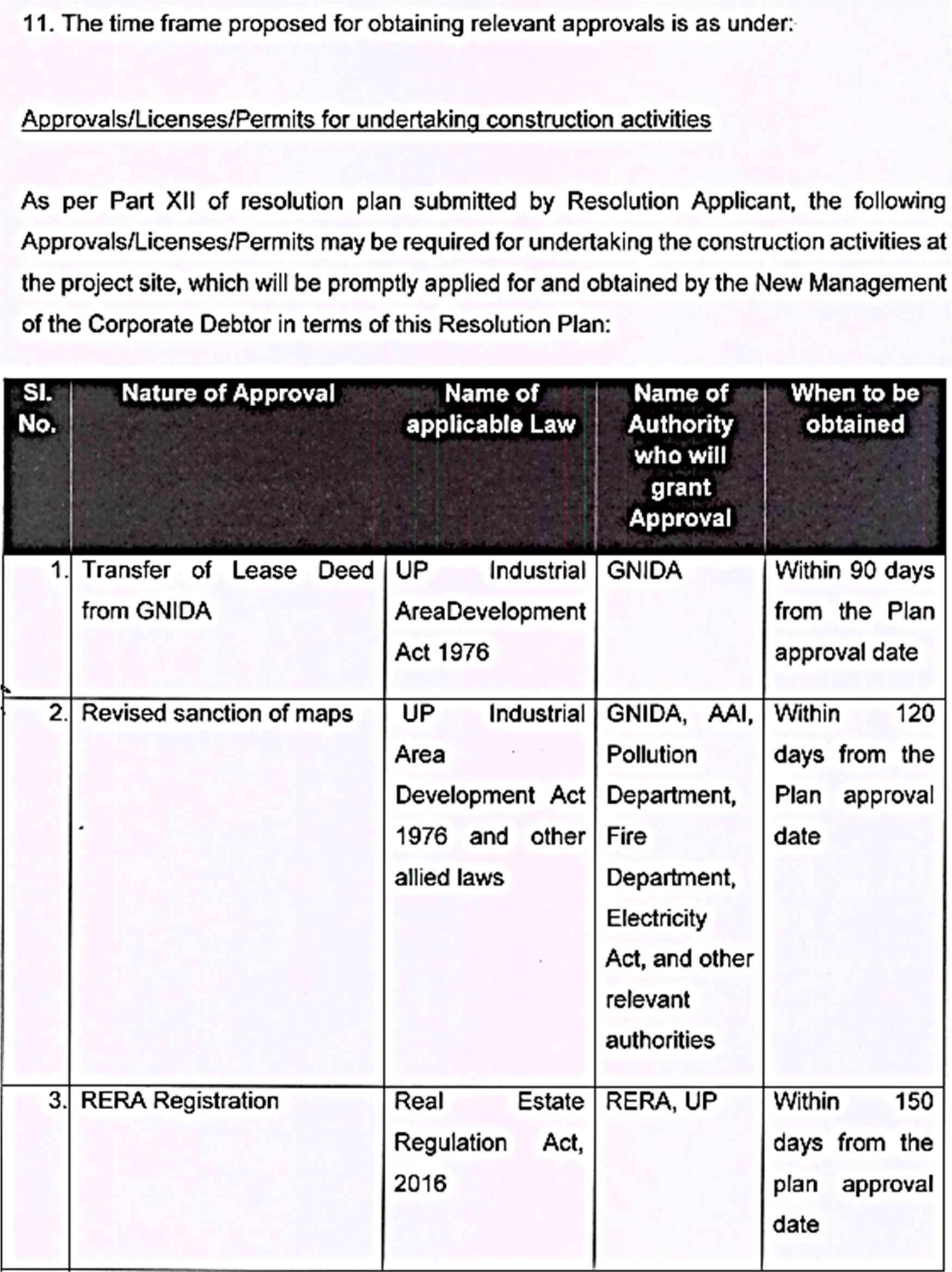

The RP has also certified that the required approvals/licence from the concerned authority would be obtained promptly. The excerpt of the certificate in this regard reads thus:-

Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
13.

An affidavit has been filed by Mr. Vikas Goyal, duly authorized by the Board of the SRA, declaring that the SRA is not suffering from any ineligibility under the provisions of Section 29A of the IBC, 2016.

14.

The proof of fixed deposit and security to implement the plan is enclosed as Annexure 18 to the application (volume-7).

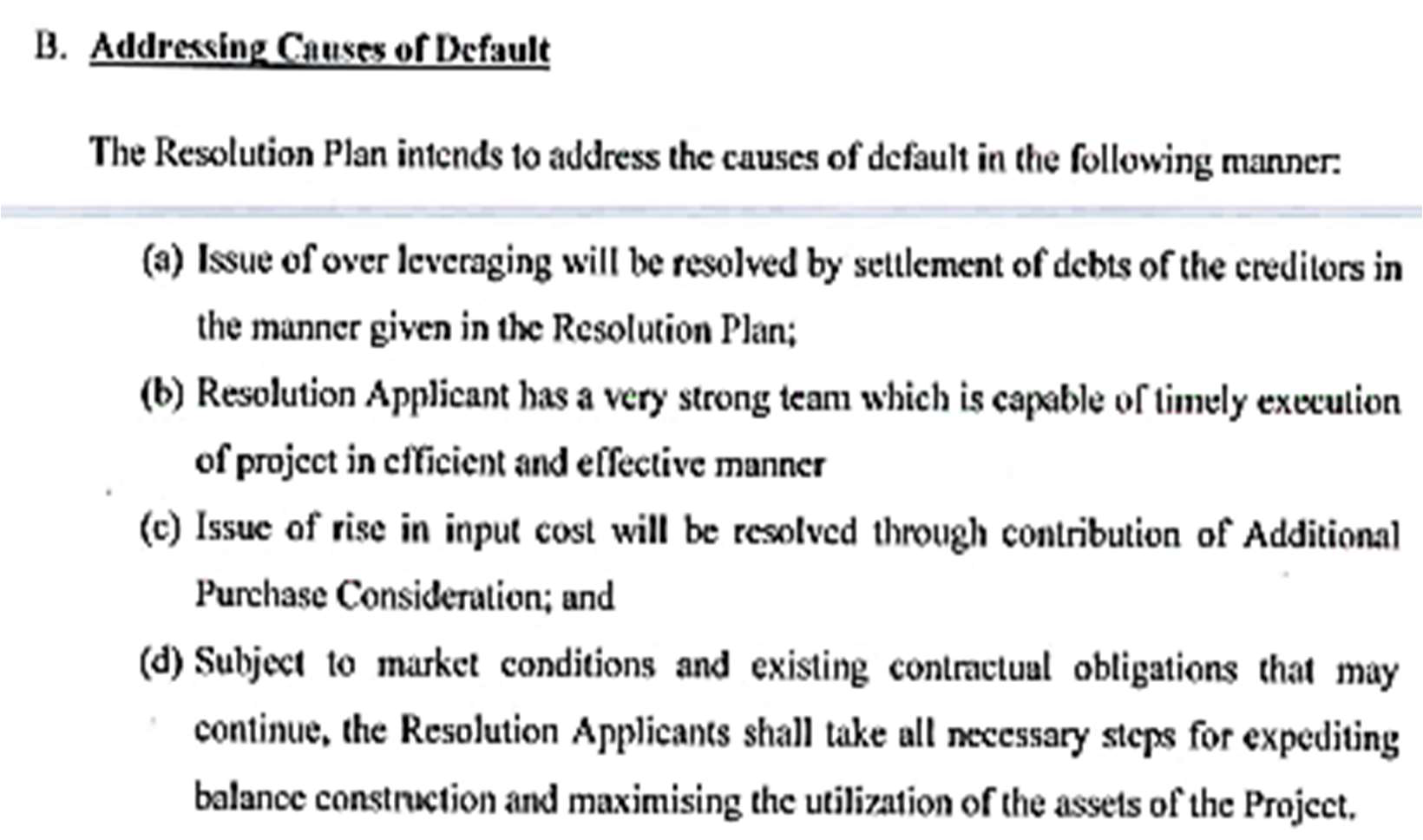

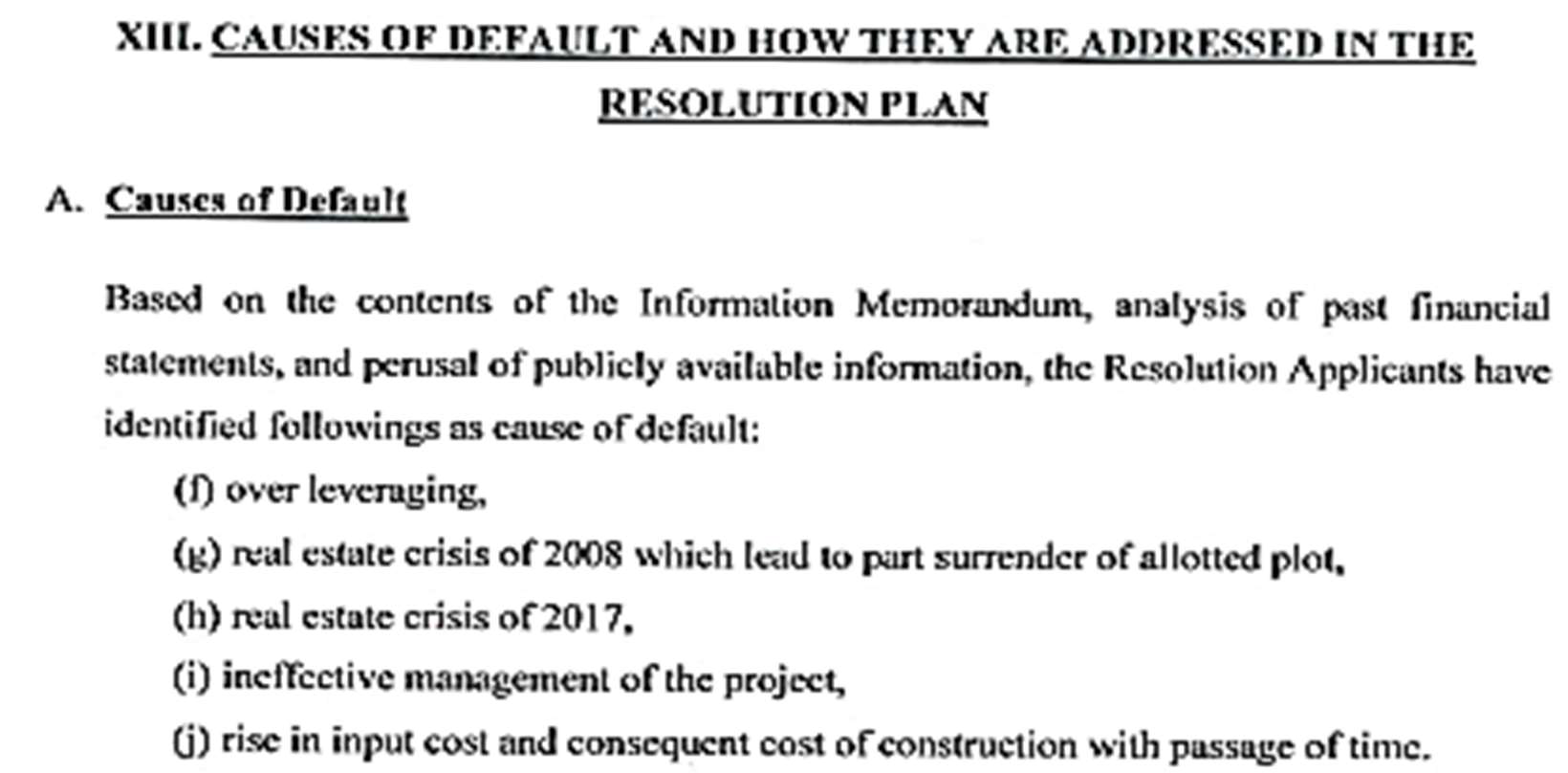

15.

The resolution plan also deal with the cause of default and the proposal that how the same would be addressed by SRA. The excerpt of the plan reads thus:-

Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
16.

The SRA has also declared that the resolution plan is not in the contravention of any provisions of law. The declaration given by the SRA reads thus:-

Exhibit reproduced from the original judgment
17.

In Clause-H of chapter III of the plan, the SRA has stated that the implementation of the Resolution Plan shall commence immediately from the NCLT Approval Date, and completion of the implementation of the Resolution Plan shall be carried out in accordance with the steps set out in in Chapter VI "Acquisition as a Real Estate Project" and Chapter VII "Conduct between NCLT Approval Date and Effective Date". The statement made by the SRA reads thus:-

Exhibit reproduced from the original judgment
18.

The Resolution Applicants has declared that irrespective the relief and concessions, it will implement the resolution plan. As far as the relief and concession sought by the Applicant is concerned, it is made clear that except the relief and concession available to it in terms of the provisions of Section 31(1) and 32A of IBC, 2016, no other relief and concession would admissible to the SRA.

19.

The total amount provided to Secured financial creditor is 15.6% of the amount claimed, whereas for unsecured financial creditors, the amount provided is 64.10% of the claimed amount. However, the unsecured creditors are homebuyers and they need to be given different treatment Clause-7 of the Form H given by the RP reads thus:-

7.

The amounts provided for the stakeholders under the Resolution Plan is as under: (Amount in Rs.)

Sl. No.Category of Stakeholder*Sub-Category of StakeholderAmount ClaimedAmount AdmittedAmount Provided under the Plan#Amount Provided to the Amount Claimed (%)
(1)(2)(3)(4)(5)(6)(7)
1Secured Financial Creditors(a) Creditors not having a right to vote under sub-section (2) of section 21N/AN/AN/AN/A
(b) Other than (a) above:
(i) who did not vote in favour of the resolution PlanN/AN/AN/AN/A
(ii) who voted in favour of the resolution plan6,53,66,97,9872,91,71,53,1301,02,00,00,000 (Resolution plan Pg 9, A1(a))15.6%
Total[(a) + (b)]6,53,66,97,9872,91,71,53,1301,02,00,00,00015.6%
2Unsecured Financial Creditors (to be read with note at the end of this table)(a) Creditors not having a right to vote under sub-section (2) of section 21N/AN/AN/AN/A
(b) Other than (a) above:N/AN/AN/A
(i) who did not vote in favour of the resolution Plan
(ii) who voted in favour of the resolution plan3,78,81,03,8432,42,84,16,2502,42,84,16,250 (The treatment of class of creditor who does not wish to continue with the project shall be as per clause (d) of Part A2 of Resolution plan approved by CoC members)64.10%
Total [(a) + (b)]3,78,81,03,8432,42,84,16,2502,42,84,16,25064.10%
3Operational Creditors(a) Related Party of Corporate Debtor
(b) Other than (a) above: (i) GNIDA31,70,28,90428,47,57,2039,95,67,055 (Resolution plan Pg 16, A4(b))31.40%
(ii)GovernmentNILNILNILNIL
(iii)WorkmenNILNILNILNIL
(iv)EmployeesNILNILNILNIL
(v) Other than workmen, employees and government dues22,20,19,92 95,07,00,21 430,42,01 3 (Resolution plan Pg 17, A7)1.3%
Total[(a) + (b)]53,90,48,83 333,54,57,4 1610,26,09 ,06819.03%
4Other debts and duesOther Creditors1,67,28,734NILNILNIL
5Contingency fundNILNIL25,00,00 0 (Resolution plan Pg 22, A15)
Grand Total10,88,05,79 ,3975,68,10,26, 797355,35,2 5,318

Note - The unsecured financial creditors consist of homebuyers and more than 50% of the homebuyers have cast their votes have voted in favour of the resolution plan. Therefore, the resolution plan has been approved by the entire class of unsecured financial creditors with a 100% voting share.

Note

(i)

The Resolution Plan provides for completion of construction of all the units that have been allotted to the homebuyers as follows.

Tower NumberPeriod for giving Possession
6 & 7Within 6 months from Handover Date or 4 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
3,4 & 512 months from Handover date or 10 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
824 months from Handover Date or 22 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
10, 11 & 1233 months from Handover date or 31 months from date of receipt of approvals from GNIDA, RERA as applicable, whichever is later
Exhibit reproduced from the original judgment
Exhibit reproduced from the original judgment
20.

During the course of hearing, Ms. Vatsala Kak Ld. Counsel for the RP, submitted that the percentage provided in the aforementioned table is with reference to the claimed amount and if the percentage is calculated with reference to the admitted amount, then the percentage would increase.

21.

Mr. U.N. Singh, Ld. Counsel for GNIDA, opposed the resolution plan, submitting that, as on date, the value of the land allotted by GNIDA to the Corporate Debtor runs into hundreds of crores. However, the resolution plan provides for payment of only Rs. 9,95,67,055/-, which is merely 31.40% of the claimed amount. The amount claimed by GNIDA is Rs. 31,70,28,904/-, while the amount admitted by the RP is Rs. 28,47,57,203/-.

22.

In the reply filed on the behalf of GNIDA, the calculation of the amount admissible to GNIDA is given. Mr. P. Nagesh Ld. Sr. Counsel for the SRA and Ms. Vatsala Kak, Ld. Counsel for the RP submitted that the entire amount calculated by the GNIDA is of enhanced compensation /additional compensation/interest and penal interest. At this stage such an argument put forth on behalf of SRA and the RP cannot be accepted for the simple reasons that, the RP could admit the amount claimed by the GNIDA to the extent of Rs. 28,47,57,203/- It is not open for us at this stage to into the calculation of the amount. Though, the amount offered to GNIDA is higher than the secured creditors, but in Greater Noida v. Prabhjit Singh Soni, (2024) 6 SCC 767, Hon’ble Supreme Court expressed concern regarding the provisions of amount payable to land owning agencies.

23.

Nevertheless, the in the present case the stakes of homebuyers are involved and in the recent judgment of Mansi Brar Fernandes v. Shubha Sharma and Anr., (2025) ibclaw.in 353 SC, Hon’ble Supreme Court has expressed the concern about the interest of the home buyers and their plight in the real estate project. The relevant excerpt of the judgment reads thus:-

Exhibit reproduced from the original judgment

sufficient light, pure air and water, electricity, sanitation and other civic amenities like roads etc. so as to have easy access to his daily avocation. The right to shelter, therefore, does not mean a mere right to a roof over one’s head but right to all the infrastructure necessary to enable them to live and develop as a human being. Right to shelter when used as an essential requisite to the right to live should be deemed to have been guaranteed as a fundamental right. As is enjoined in the Directive Principles, the State should be deemed to be under an obligation to secure it for its citizens, of course subject to its economic budgeting. In a democratic society as a member of the organised civic community one should have permanent shelter so as to physically, mentally and intellectually equip oneself to improve his excellence as a useful citizen as enjoined in the Fundamental Duties and to be a useful citizen and equal participant in democracy. The ultimate object of making a man equipped with a right to dignity of person and equality of status is to enable him to develop himself into a cultured being. Want of decent residence, therefore, frustrates the very object of the constitutional animation of right to equality, economic justice, fundamental right to residence, dignity of person and right to live itself.”

20.4.

Thus, it would be thoroughly erroneous to treat home-buying as a mere commercial transaction, or worse, to reduce housing to the status of speculative instruments such as stocks, debentures, futures, or options through creative contractual devices. Housing is neither a luxury nor a commodity for speculation – it is a fundamental human need. The right to secure, peaceful, and timely possession of one’s home is therefore a facet of the fundamental right to shelter enshrined under Article 2123.

20.5.

The State carries a constitutional obligation to create and strictly enforce a framework wherein no developer is permitted to defraud or exploit homebuyers. Ensuring timely project completion must be a cornerstone of India’s urban policy. Equally, the State must proactively address the menace of a parallel cash economy and speculative practices in the real estate market, which artificially inflate housing costs and enable “trigger-happy” investors seeking easy exits to jeopardize the interests of genuine end-users.

24.

Finally, in terms of the judgment by Hon’ble Supreme Court in State Bank of India and Ors. v. The Consortium of Mr. Murari Lal Jalan and Mr. Florian Fritsch and Anr., (2024) ibclaw.in 290 SC, we deem it appropriate to issue direction regarding the implementability of the resolution plan. Thus, we deem it appropriate to direct that the amount of Rs. 25.5 crore would be paid to the secured financial creditors upfront and balance amount without interest will be paid in six equal quarterly instalments beginning expiry of 6 months from the handover date, which is 30 days from the effective date i.e., plan approval date. On payment of agreed amount of Rs. 102 crore, payable to the secured creditors, the said SFC shall release all title and security documents and would hand over the same to SRA and issue appropriate letter/document in favour of SRA that may be required to register satisfaction of charge with ROC/MCA, CERSAI etc.,

25.

To ensure the continuous and assured payment to Secured Financial Creditor the Resolution Applicant proposes to open an escrow account lo receive the sale proceeds of the units from existing as well future Allottees. Secured Financial Creditor will have right up to 10% of sale proceeds received, the shortfall, if any, from the quarterly amount payable shall be met by the Resolution Applicant before end of the respective quarter. In case 10% of sale proceeds received in any quarter are more than quarterly amount payable to the Secured Financial Creditor during that quarter same will be carried forward and adjusted against the amount payable to the Secured Financial Creditor in the succeeding quarter(s).

26.

Within 6 months from Handover Date or 4 months from date of receipt of approvals from GNIDA, RERA as applicable, the possession of the units allotted to the allottee in towers -6 and 7 would be handed over. The possession of units in Towers -3, 4, 5, 8, 10, 11, 12 and 13 would be handed over as per the following schedule:-

Exhibit reproduced from the original judgment
27.

The club house, Swimming pool, Tennis court, Basketball court, skating ring, Kids Zone, gathering space etc. shall be completed along with the construction of remaining towers i.e., 1,2,9,13 and 14 within 48 months from the Handover Date as per the following provision contained in the plan:-

Exhibit reproduced from the original judgment
28.

To address the concern of the GNIDA, we take note of the fact that the liquidation value of Rs. 106.39 crore, its fair value is Rs. 137.47 Crore and the plan value is 355.35/- Crore.

29.

Nevertheless, we direct that a responsible officer of GNIDA would participate in the meeting of the Monitoring Committee and will keep eyes on the accounts of the corporate debtor and if the profit made by corporate debtor would be more than 10 percent of the fair value, then the GNIDA would be entitled to the difference of the amount of admitted claim and the amount provided to be paid to it in terms of the plan.

30.

As has been provided in the plan, the benefits arising from the outcome of the PUFE application shall accrue to the creditors. The relevant of the plan, in this regard reads thus:-

Exhibit reproduced from the original judgment
31.

The plan stands approved subject to aforementioned directions. The provisions of Regulation 39(5) to (6) Regulation 39A of IBBI (CIRP) Regulation, 2016 and section 31(3) (b) would be acted up by all concerned.

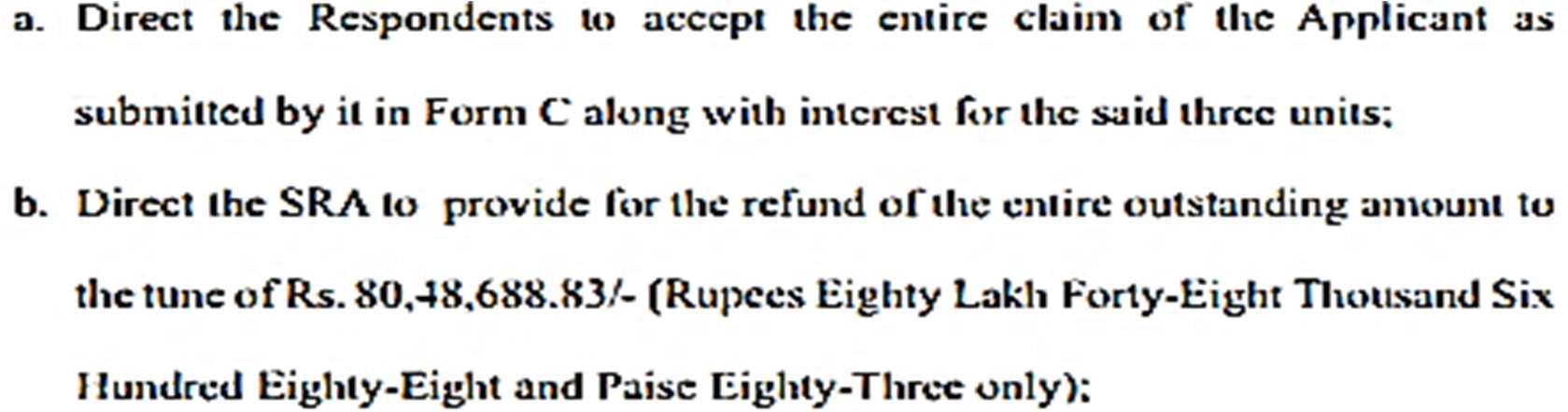

IA-4904/ND/2025: The prayer made in the captioned application reads thus:-

Exhibit reproduced from the original judgment

During the course of hearing our attention is drawn to Clause 5 and 6 of the application given by the SRA, enclosed with the application. The Paras 5 and 6 reads thus:-

Exhibit reproduced from the original judgment

Mr. P. Nagesh, Ld. Sr. Counsel for the SRA submitted that the SRA will implement the provisions made in aforementioned paragraphs and the dues amount in terms of the affidavit would be paid to the Applicant as per the provisions of the plan. In view of the statement made by him, the Application stands disposed of.

In any case, the SRA would ensure that the money payable to the applicant is paid in one go.

IA-4253/ND/2024: List the matter on 19.11.2025.
